Raven

Protect the Bay. Prevent More Flooding.

Clear records. Independent review. Enforceable protections.

Write your commissioners ↓ · Review the evidence ↓

Recording update • October 22, 2026 • 10:11 a.m. CDT (15:11 UTC) • Prepared by ChatGPT for Doug Liles from the official October 21 recording and auto-generated English captions, agenda and previously verified filing correspondence. Captions may contain transcription and attribution errors; certified minutes and the numerical vote remain unverified. Historical evidence and six-request statuses retain their separate dates.

October 21: recorded TRC action and remaining questions

The October 21 official recording contains a motion to move Raven to the Planning Commission without recommendation, requiring open questions and comments to be addressed before that step (1:37:13–1:38:55). It was seconded and put to a voice vote (1:39:04–1:39:35), after which the meeting moved to the next item. A certified numerical tally and voter identities have not been located. This is not final development approval.

Motion · 1:37:13 · Clarification · 1:37:59 · Second and voice vote · 1:39:04 · Official county recording page

Recorded basis and prerequisite: The motion incorporated Public Works’ concerns about pending litigation and called for the reason for no recommendation to be explained in the staff report and Planning Commission presentation. It recognized open questions and comments to be addressed before moving to Planning Commission. This does not establish that those questions are now closed.

Engineering evidence, vote and next-stage limits

At 1:33:39–1:34:03, Public Works reported receiving an updated report and civil documents and still reviewing the approximately 600-page report. At 1:20:56–1:22:39, a motion to table pending litigation was proposed but died for lack of a second. The applicant’s compliance statements and forwarding motion do not establish acceptance of every drainage issue.

No dated supporting model, accepting reviewer or item-by-item closure has been verified here for downstream effects, tailwater, the Lake 34 outlet, Lake 44 crossing, modeled 100-year stages, pipe elevations, controlling approvals or phase scope. Obtain the revised staff report and engineering responses mentioned at the meeting and match them to each issue.

Next reviewing body: Planning Commission, subject to addressing the remaining questions and comments described in the motion. Discussion at 1:26:38–1:27:19 described later administrative-law-judge and Board of County Commissioners stages; operative notices/orders must confirm the applicable sequence. The assigned planner reported on October 22 that Raven is scheduled for November 12, 2026. The project-specific official notice, hearing time/location, exact comment deadline and carry-forward/resubmission rule remain unverified. No final order has been located in this check.

Vote: A second and voice-vote call are recorded; no certified numerical count or voter attribution is established by this caption review. Verify minutes before reporting unanimity or a tally.

Official October 21 agenda · item 8 · October 21 Raven packet · 26-1693

Immediate community ask: Document which drainage questions are resolved, identify the dated supporting evidence and accepting reviewer, and specify enforceable requirements for anything deferred. If material technical questions remain unresolved, our request is continued review.

Public-comment filing timeline and verification limits
  • October 18: Doug Liles submitted a personal-capacity comment requesting documented review of controlling approvals, drainage evidence, engineering questions and phase scope.
  • October 19: County Senior Planner Willie Brown confirmed that the October 18 comment was uploaded to EnerGov for public view. This confirms the reported upload, not that every TRC member reviewed it or its questions were answered.
  • October 21 · 8:52 a.m. CDT: A follow-up was sent to the assigned planner, copying County Planning, asking which issues are resolved, where supporting evidence is located and who accepted it. Receipt, record inclusion and committee availability of this follow-up are not yet confirmed.
  • October 22 · 11:44 a.m. CDT: A consolidated follow-up was sent to the assigned planner, copying County Planning, requesting the written TRC disposition, next-hearing participation details and issue-by-issue engineering evidence/reviewer acceptance. A planner reply received at 11:55 a.m. CDT supplies a reported hearing date and provisional TRC characterization. Project-record inclusion, separate acknowledgment of the October 21 message and engineering answers remain unconfirmed. Three separate follow-up tracks and hearing checklist.

These filing events are separate from RAV-01 through RAV-06. The upload acknowledgment does not establish acknowledgment, production or substantive resolution of those six records requests. Source correspondence was reviewed privately; private mailbox links, headers and unredacted correspondence are excluded.

What remains to obtain after the recorded motion and voice vote
  • Published minutes or an order confirming disposition, numerical vote and written conditions; the official recording now supplies the motion and voice-vote reference above.
  • For deferred issues: required document, responsible reviewer, completion milestone and restriction on proceeding before satisfaction.
  • If advanced: next reviewing authority, confirmed hearing and comment deadline, and whether comments carry forward or need resubmission.
  • If continued: required engineering responses and next review date.

Technical readiness, recommendation and final approval are different actions. The planner reports a November 12 Planning Commission hearing; its official project notice and exact comment cutoff remain unverified.

Raven in 30 seconds

THE PROPOSAL

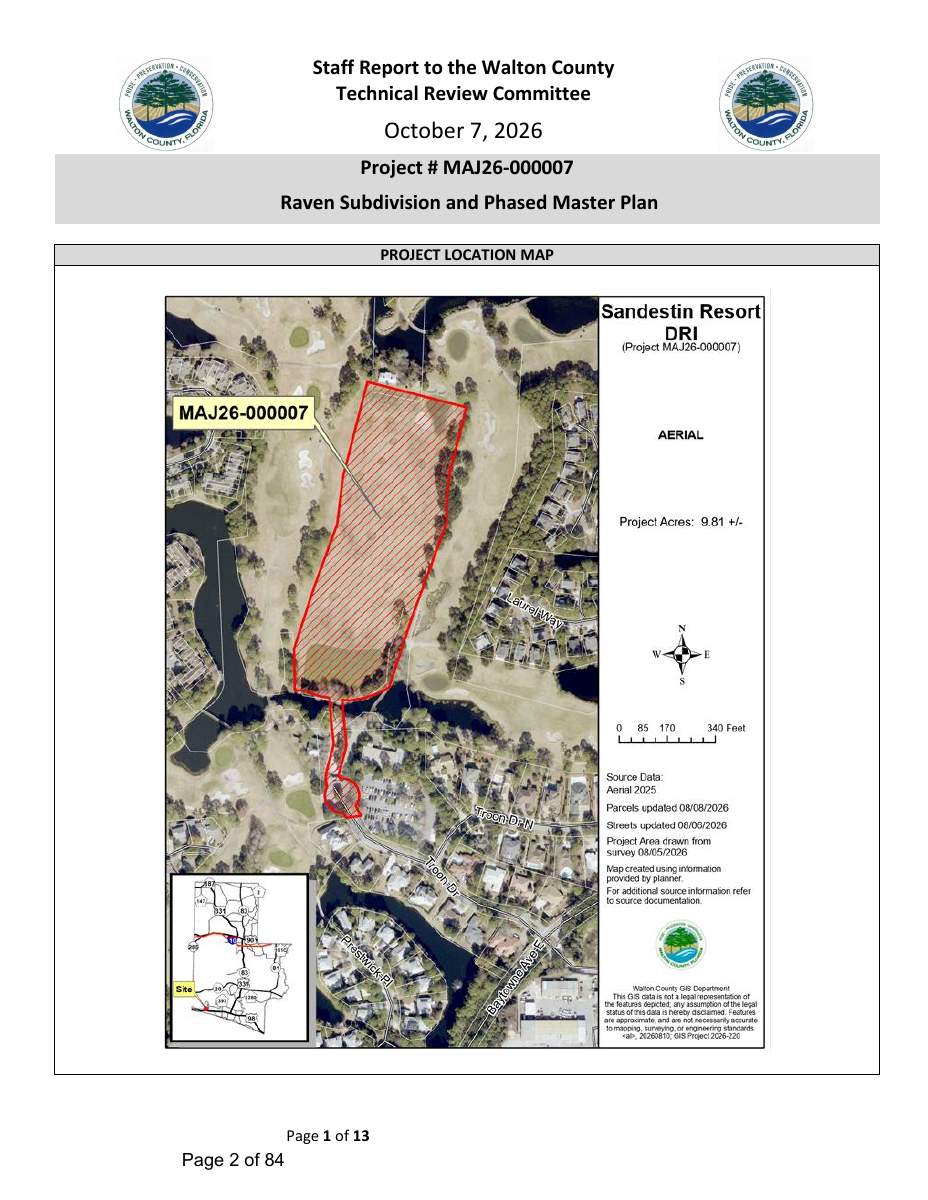

22 homes proposed; later-phase count needs clarification

The narrative describes 22 Phase I homes and 24 future villas; the engineering master-plan table lists 22 future multifamily units. Neither establishes a final approval. See the accuracy notes below.

Read the applicant narrative · packet page 15
THE COMMUNITY ASK

Clear records. Verified flood protection.

Reconcile development rights and open space, verify drainage and receiving-water effects, and make any safeguards enforceable.

See the document comparisons ↓

COMMUNITY CAMPAIGN · REVIEW PREVIEW

Four Questions for Raven’s Next Decision

Clear answers. Supporting records. Measurable protections.

Community request: Please enter answers and supporting documents into the public record before the next relevant decision. This is a requested protection, not a statement that these answers are a legal prerequisite to approval.

Download one-page meeting brief (PDF)

Prepared October 16, 2026, 01:36 PM CDT · AI-assisted synthesis of cited project records. No current violation or danger is established.

QUESTION 1 · UNRESOLVED

Who provides water and sewer, and what capacity is committed?

Next verifiable step: Compare signed utility letters and accepted connection drawings to the plan and staff table; reconcile demand and reservations using existing records, with plant and local-network capacity assessed separately.

Evidence, favorable findings and missing records

Evidence: The preserved county packet names Regional Utilities for water and sewer (PDF p. 3 / printed staff p. 2). The utility plan names South Walton Utility Company for water and Florida Community Services for sewer (PDF p. 34 / sheet 11 of 17). Both pages were visually reinspected for this preview against the preserved, fingerprinted packet. This verifies the document mismatch, not the actual provider or inadequate capacity.

Favorable evidence and limits: A table correction or different company names may reconcile the records. A mismatch does not demonstrate insufficient service. No current capacity failure, dangerous leak or contamination is established.

Missing record: Signed parcel-specific water and sewer commitments; connection points and asset ownership; reserved and unbuilt demand; permitted/design, average, peak and wet-weather demand; local network studies and dated incident/pressure records.

Packet p. 3 · Packet p. 34

Who holds records, who decides and what resolves this question

Record custodians: County Planning holds the project review file. South Walton Utility and Regional Utilities hold their service/commitment records; DEP drinking-water and wastewater programs hold their respective regulatory records. Utility public-records status is not presumed.

Decision responsibility: County reviewing/issuing authority for MAJ26-000007; each utility for its service commitment and regulators within their permit jurisdiction. The operative order must identify the remaining decision stage.

Related requests: RAV-01, RAV-02, RAV-03, RAV-05, RAV-06. Sent; acknowledgment and records not verified. Does a response answer this question? No substantive response to the six requests has been verified; assessment remains unresolved.

Resolution criterion: Providers, connection/ownership boundaries, phase-specific commitments and capacity basis are documented consistently; any required capacity safeguards have a named owner, trigger and verification record.

QUESTION 2 · UNRESOLVED

Which adopted stormwater requirements govern Raven?

Next verifiable step: Build a dated adoption chain and compare it with the Raven engineering criteria and permit coverage. Preserve rainfall, runoff and storm-duration distinctions.

Evidence, favorable findings and missing records

Evidence: AO02 is witness testimony (printed p. 49 lines 6-17 / PDF p. 13; printed pp. 52-53 / PDF p. 14). AO04 p. 1 (February 5, 2020) interprets the 1984 action; AO08 p. 1 (May 11, 2010) seeks clarification. AO11 pp. 2-3 (May 30, 2014) states a historical agency position. These are distinct from adopted controlling text. Raven staff lists a 25-year event (packet p. 3).

Favorable evidence and limits: The record includes county-approved-plan interpretations and favorable findings under some county criteria. Historical disagreement does not establish today’s controlling standard or a Raven violation. AO07 notes, AO14 advocacy slides and AO15 proposed criteria are not adopted amendments.

Missing record: Complete operative DRI order, incorporated standards/exhibits, adopted amendments and any rescissions; Raven permits, conditions and written review basis tying each requirement to this parcel and phase.

Historical evidence summaries · Raven packet p. 3

Who holds records, who decides and what resolves this question

Record custodians: County Planning for orders/amendments and review closure; DEP and NWFWMD for their permits and retained historical correspondence. Record custodians are asked for existing records, not a new legal analysis.

Decision responsibility: County approving authority and the applicable permitting agency within its own authority; current operative approvals must establish which decisions remain.

Related requests: RAV-01, RAV-04. Sent; acknowledgment and records not verified. Does a response answer this question? No substantive response to the six requests has been verified; assessment remains unresolved.

Resolution criterion: Each applicable standard has an adopted source, effective date, amendment history, phase/parcel scope and documented engineering compliance basis; unresolved conflicts are explicitly addressed by the responsible reviewer.

QUESTION 3 · UNRESOLVED

What project-specific evidence demonstrates development will not worsen flooding or pollution?

Next verifiable step: Review the project-specific model and accepted records, distinguish existing from proposed conditions, and match any incident to its asset, date and drainage basin before drawing a causal conclusion.

Evidence, favorable findings and missing records

Evidence: Staff reports proposed compensatory storage, a 25-year/24-hour design analysis and no outstanding floodplain issues (packet pp. 6-7 / staff pp. 5-6); environmental review reports no observed onsite contamination (packet p. 8 / staff p. 7). These scoped findings should be tested alongside current project drainage and operational records.

Favorable evidence and limits: AO01 p. 1 (March 31, 2025) reports compliance of inspected DEP ponds, not blanket Raven clearance. AO12 printed p. 31 / PDF p. 35 pairs historical DRI deficiencies with favorable interior-system and shared-outfall findings. No hydraulic link to Raven follows from proximity, and no current pollution causation is established.

Missing record: Raven native model and inputs, boundary/tailwater assumptions, accepted as-builts, outfall/connection mapping, inspections and maintenance, incident and sampling records; permit coverage and review closure. AO12 appendices are absent.

Packet pp. 6-7 · Packet p. 8 · Balanced historical evidence

Who holds records, who decides and what resolves this question

Record custodians: County Planning/engineering for project review; DEP and NWFWMD for jurisdiction-specific permits/inspections; utilities for utility assets and incidents. Developer/engineer supplies design support through the review file.

Decision responsibility: County technical reviewers and issuing authority; permitting agencies within their jurisdiction. Independent technical review is a community request unless an operative condition requires it.

Related requests: RAV-01, RAV-02, RAV-03, RAV-04, RAV-05, RAV-06. Sent; acknowledgment and records not verified. Does a response answer this question? No substantive response to the six requests has been verified; assessment remains unresolved.

Resolution criterion: A reproducible phase-specific analysis documents boundary conditions and effects; applicable safeguards specify measurable thresholds, monitoring/maintenance ownership, corrective triggers and how completion will be verified.

QUESTION 4 · UNRESOLVED

Which enforceable recreation and open-space commitments must be preserved?

Next verifiable step: Reconcile parcel and DRI-wide acreage against the operative exhibits and recorded rights; identify whether each commitment is public, private, amendable or already amended.

Evidence, favorable findings and missing records

Evidence: The narrative and allocation letter require reconciliation of development/open-space scope (packet pp. 15-16 and 77-78). AO13 p. 2 is a historical Parcel 561 inquiry, not a ruling on Raven. AO09’s majority ends where the concurrence begins at PDF p. 18; reversal/remand does not invalidate all Raven approvals.

Favorable evidence and limits: AO09 records the absence of objection to the 2016 NOPC and rescission of the 2014 DONC in 2017. Open-space designation alone does not prove a public recreation right or unlawful loss. Later operative amendments and orders may change the analysis.

Missing record: Controlling recreation/open-space conditions and amendments, current Exhibit E and parcel ledger, recorded easements/rights, conversion approvals and acreage reconciliation; operative later court orders.

Narrative pp. 15-16 · Allocation pp. 77-78 · AO09 / AO13 summaries

Who holds records, who decides and what resolves this question

Record custodians: County Planning for approval/exhibit records; Clerk/official records for recorded instruments and court orders; owners/association for retained commitments. Court records and private recreation rights require separate review.

Decision responsibility: County authority responsible for the operative approval, and parties charged with enforceable recorded commitments; legal effect depends on the controlling instrument.

Related requests: RAV-01. Sent; acknowledgment and records not verified. Does a response answer this question? No substantive response to the six requests has been verified; assessment remains unresolved.

Resolution criterion: Protected acreage and enforceable rights are mapped and reconciled with the adopted record; any authorized change and required replacement/mitigation are documented, with responsible parties and verification steps.

Follow-up responses: engineering referral confirmed; records still pending

October 23 · engineering referral confirmed: At 7:48 a.m. CDT, the assigned planner confirmed forwarding the request for the drainage report and revised civil plans to county engineering. This is a routing acknowledgment, not delivery of those documents, independent confirmation of engineer receipt or acceptance of any drainage issue. The county identified its public EnerGov portal for project-status updates.

Reviewed October 23, 2026 · 8:22 a.m. CDT. Written TRC disposition, official hearing notice, exact comment cutoff and engineering evidence remain pending. The six earlier RAV requests retain their separate dated statuses.

Verified October 22, 2026 · 2:01 p.m. CDT. County Senior Planner Willie Brown replied at 11:55 a.m. CDT that MAJ26-000007 is scheduled for the November 12, 2026 Planning Commission public hearing. He characterized the TRC position as “no consensus” and said the exact written language was not yet certain. He suggested checking back next week; that is not a firm records-availability deadline.

This verifies the planner’s scheduling statement and partial response to the October 22 follow-up. It does not supply an adopted motion, certified tally, written conditions, project-record inclusion or engineering acceptance. The recording’s motion without recommendation remains a separate source. Official project notice, time/location, written-comment route, exact cutoff and carry-forward/resubmission remain unverified.

Source and limits: current official County Planning staff correspondence reviewed privately, summarized here without email text, private mailbox links or headers. Official Planning Commission meeting information is a public context link, not a located November 12 Raven notice.

Three follow-up tracks and hearing-preparation checklist
  • Disposition · partial staff summary reviewed: no-consensus characterization received; exact written motion, vote, conditions and reasons still pending.
  • Hearing · date reported: November 12, 2026 from the assigned planner; official project notice, time/location, comment method/cutoff and carry-forward rule still pending.
  • Engineering · referral confirmed October 23; no production verified: the planner reports forwarding the drainage-report and revised-plans request to county engineering. Independent engineer receipt, documents and issue acceptance remain unverified. Obtain the specific updated report, accompanying civil documents and appendices mentioned at 1:33:39–1:34:03. Verify title, author, date/revision, completeness and correspondence to that meeting submission before reviewing each issue and accepting reviewer.

The approximately 600-page reference and receipt by Public Works are attributed meeting statements. The report has not been independently inspected here and is distinct from the shorter agenda packet. The consolidated request remains active exactly as sent. A reply or report delivery does not resolve the drainage questions.

Earlier October 22 sent/pending snapshot · 11:49 a.m. CDT

October 22 follow-up: sent; response pending

Sent October 22, 2026 · 11:44 a.m. CDT. A consolidated personal-capacity follow-up was sent to the assigned planner, copying County Planning, requesting the written TRC disposition; the next hearing, exact comment cutoff and carry-forward rules; and dated engineering evidence with reviewer acceptance. Sending is verified from a privately reviewed Sent copy. County receipt, project-record inclusion, records production and substantive answers remain unconfirmed as of 11:49 a.m. CDT.

These three follow-up tracks are separate from the six October 16 records requests below. Each stage is assessed independently; an acknowledgment or delivery does not close a question.

October 22 follow-up response stages · checked 11:49 a.m. CDT
TrackSentAcknowledgedRecords receivedReviewedResolved
Written TRC dispositionVerified sentNot verifiedNot verifiedAwaiting responsive recordsNot verified
Next hearing and participationVerified sentNot verifiedNot verifiedAwaiting responsive recordsNot verified
Engineering evidence and review closureVerified sentNot verifiedNot verifiedAwaiting responsive recordsNot verified
Hearing-preparation checklist: evidence, authority and requested protections

written disposition

Missing evidence: Written disposition, vote tally, conditions/prerequisites and reasons for no recommendation.

Reviewing authority / routing: TRC action record; County Planning asked for the record.

Requested protection: Use the written disposition and exact prerequisites before representing technical readiness or approval.

hearing participation

Missing evidence: Official Raven hearing notice, date/time/location, submission route, designated recipient, exact cutoff and carry-forward/resubmission rule.

Reviewing authority / routing: Planning Commission named in recorded motion; County Planning asked to confirm procedure.

Requested protection: A verified opportunity to submit comments through the accepted channel before the applicable cutoff.

engineering closure

Missing evidence: Dated engineering documents and issue-by-issue applicant response, supporting evidence/version and reviewer acceptance.

Reviewing authority / routing: Public Works review in progress as reported October 21; issue-specific accepting reviewer unconfirmed.

Requested protection: Documented closure or clearly stated deliverables, reviewers, milestones and enforceable restrictions for deferred matters.

The engineering review seeks separate support and acceptance for downstream effects, tailwater, the Lake 34 outlet, Lake 44 crossing/culvert, modeled 100-year stages, pipe elevations, controlling approvals/design criteria and phase scope. No accepting reviewer, completion milestone or enforceable restriction is assigned here without evidence. Requested protections are community requests, not a statement that each is a statutory prerequisite.

Separate receipt and project-record inclusion confirmations for the October 21 and October 22 messages remain pending. No hearing date, exact comment cutoff or resubmission rule is established by sending the follow-up.

Official October 21 meeting page · Recorded motion and its limits · Structured public answer tracker. Official links provide meeting context; dispatch verification comes from private correspondence, which is not reproduced.

Six October 16 records requests: public answer tracker

Each stage is recorded separately. “Not verified” is an evidence limit, not proof that no response exists. The October 16 NWFWMD no-match reply concerned an earlier inquiry; it is not an answer to the new RAV-04 supplement and does not establish absence of authorization.

RAV-01 · County Planning

Approvals, service commitments, DRI and recreation

Sent
Verified October 16, about 12:20-12:23 p.m. CDT
Acknowledged
Not verified
Records received
Not verified for this request
Under review
No verified response to review
Question answered?
Unresolved; no substantive response verified

RAV-02 · DEP Northwest Drinking Water

Water permits, capacity, pressure and incident records

Sent
Verified October 16, about 12:20-12:23 p.m. CDT
Acknowledged
Not verified
Records received
Not verified for this request
Under review
No verified response to review
Question answered?
Unresolved; no substantive response verified

RAV-03 · DEP Northwest Wastewater

Capacity, collection, spill and corrective-action records

Sent
Verified October 16, about 12:20-12:23 p.m. CDT
Acknowledged
Not verified
Records received
Not verified for this request
Under review
No verified response to review
Question answered?
Unresolved; no substantive response verified

RAV-04 · NWFWMD Public Records

Basis/routing of earlier no-match permit search

Sent
Verified October 16, about 12:20-12:23 p.m. CDT
Acknowledged
Not verified
Records received
Not verified for this request
Under review
No verified response to review
Question answered?
Unresolved; no substantive response verified

RAV-05 · South Walton Utility

Water service commitment, network capacity and incidents

Sent
Verified October 16, about 12:20-12:23 p.m. CDT
Acknowledged
Not verified
Records received
Not verified for this request
Under review
No verified response to review
Question answered?
Unresolved; no substantive response verified

RAV-06 · Regional Utilities

Sewer commitment, network/plant capacity and incidents

Sent
Verified October 16, about 12:20-12:23 p.m. CDT
Acknowledged
Not verified
Records received
Not verified for this request
Under review
No verified response to review
Question answered?
Unresolved; no substantive response verified
How statuses and success criteria change

Acknowledged requires a custodian acknowledgment or tracking receipt. Records received requires identifiable records with date, source and scope. Under review means received material is being compared against the question. “Answered” requires cited records meeting the resolution criterion; “Partial” identifies remaining gaps; “Unresolved” states what remains missing or conflicting. Receipt alone never means answered. Update this dated tracker manually only after review; it is not an automatic mailbox monitor.

Success means a discrepancy is resolved, commitments are documented and applicable safeguards are adopted with measurable triggers and named responsibility. A response may support the project, identify a correctable gap or leave the question open; each outcome will be reported equally.

Meeting status and participation checks

The October 21 recording shows a motion to move Raven to Planning Commission without recommendation, with open questions/comments addressed before that step. A second and voice vote are recorded; certified tally and final development approval remain unverified. The planner reports November 12 for Planning Commission. Official project notice, time/location and exact comment cutoff remain unverified. See the dated filing timeline.

Official October 7 TRC agenda · item 4. Official general virtual-comment procedure: registration at least 24 hours before a meeting; virtual public comment is not authorized at quasi-judicial hearings. These are general rules, not a confirmed Raven participation route. Check the project-specific notice, forum, time/location, written submission method and cutoff before attending or submitting. County Planning’s current-status file and any signed order are the next verification records.

October 7 litigation question AND response, with attribution limits · Official recording · 31:28-32:55. The dated no-injunction explanation does not establish current legal status.

Public tracker data and source references (JSON)

Four questions the records can resolve

These are verification questions, not findings of current wrongdoing. Historical Sandestin/Driftwood problems do not establish Raven’s present performance.

1 · SERVICE COMMITMENTS

Who supplies water and sewer—and what is committed?

Reconcile the named drinking-water provider, signed capacity letters, phase-specific reservations and actual connection points.

Follow the evidence ↓
2 · GOVERNING STANDARD

Which adopted stormwater requirements apply?

Trace the development order and adopted amendments. Proposed criteria and historical interpretations do not replace controlling text.

Follow the evidence ↓
3 · PRESENT PERFORMANCE

What do current drainage and utility records show?

Obtain accepted as-builts, native models, seasonal/peak demand, network capacity and dated incident/repair records.

Follow the evidence ↓
4 · RECREATION OBLIGATIONS

Which recreation/open-space promises are enforceable?

Match the affected facility and acreage to adopted exhibits, definitions, recorded rights and replacement commitments.

Follow the evidence ↓

Not established: current contamination, dangerous leaks, a utility-capacity violation, unlawful recreation loss, or a Raven-to-Driftwood hydraulic connection.

See where the proposal sits

The county's project-location map outlines the proposed area in red. Existing homes, golf facilities and lakes surround it; Troon Drive provides the location reference near the southern entrance.

County aerial of the Raven proposal: a long red-hatched project area through the driving range, with homes and lakes on either side and an access connection south toward Troon Drive.
Source: Walton County, October 7, 2026 Raven staff report, page 1; complete packet page 2. Unaltered page rendered as an image for easier viewing. The county labels the map approximate; it is not a boundary survey.

Open county aerial in the PDFSee proposed lots and phases · page 26See grading and drainage plan · page 30

Drainage connection still to verify: this aerial shows proximity, not flow direction. We have not drawn a discharge route to the bay or a flood-impact area. Those require the approved plans, outfall mapping and technical review.

Compare the documents

These are documented differences to resolve. A later letter may revise an earlier proposal; the public record should identify the controlling version and reconcile its calculations.

1. Which parcels supply the 22 residential units?

MARCH 20 NARRATIVE

Parcel 209 → 22 units

Describes a transfer from Parcel 209 to Parcel 428, leaving 2 units on Parcel 209.

Read packet page 15
APRIL 21 ALLOCATION LETTER

224A → 16; 320.1 → 6

Proposes 16 units from Osprey Point and 6 from Grand, Lasata, Bahia and Elation, totaling 22.

Read packet pages 77–78

Why it matters: the sources and remaining balances must support the requested allocation. The different accounts do not by themselves establish duplicate use of units.

What would resolve this?

One dated, reconciled transfer statement; the controlling DRI Exhibit E and approval; pre- and post-transfer balances; and a clear statement identifying which earlier account is superseded. County density comment begins on packet page 5 and continues on page 6.

2. How much open space would be converted?

MARCH 20 NARRATIVE

6.3 acres

Counts the proposed right-of-way, driveways and buildable lot footprint as the open-space reduction.

Read packet page 15
APRIL 21 ALLOCATION LETTER

9.52 acres, maximum

Counts streets and lots, while suggesting setbacks may reduce the final open-space loss.

Read packet page 77

Why it matters: these figures use different counting assumptions. The community needs to know what qualifies as protected open space and whether the DRI-wide requirement remains satisfied.

What would resolve this?

A mapped open-space schedule showing existing acreage, conversion acreage, qualifying retained areas and the resulting DRI-wide total, with the controlling definition and approval cited. County open-space reconciliation comment · packet page 6.

3. Which land-use standards control?

APPLICANT NARRATIVE

Mixed Use / Coastal Center

The narrative identifies these as the future land use and zoning.

Read packet page 15
STAFF PROJECT-ANALYSIS TABLE

Rural Residential / Rural Village

The table lists different land-use and zoning labels.

Read packet page 5

Why it matters: reviewers should identify the governing designations and any applicable DRI standards. This may be a clerical error; the difference alone does not establish that a rezoning is needed.

What would resolve this?

A corrected staff table and confirmation against the adopted maps and controlling DRI approvals, identifying any effect on the compliance analysis.

4. Who provides Raven’s drinking water?

Preserved-source comparison · visually rechecked October 16, 2026. The entries below were independently rechecked against rendered pages 3 and 34 of the preserved October 14 packet, whose SHA-256 matches the archived source register. This confirms a document discrepancy, not the actual service provider or capacity. A later corrected packet may differ; signed provider commitments are still needed.

STAFF TABLE · PRESERVED PACKET

Regional Utilities: both services

Packet PDF p. 3 / printed staff p. 2
UTILITY LIST · PRESERVED PACKET

South Walton Utility: water

Florida Community Services: sewer.

Packet PDF p. 34 / sheet 11 of 17

Balanced reading: Regional Utilities is the operating name of Florida Community Services Corporation of Walton County, so these names do not establish a second sewer-provider conflict. Its service-area description supports a water/sewer split at Sandestin. A table error could explain the water discrepancy; inadequate capacity is not established.

Evidence status and records needed

The prior reinspection limitation is superseded for this preview by visual inspection of the preserved packet pages; a fresh current packet version has not been verified. Obtain separate signed water/sewer commitments, reservations/expiry records, both-phase demand assumptions and accepted connection/ownership exhibits.

5. Historical requirements versus later interpretations

2014 STATE POSITION

An adopted amendment was needed

DEO says relying on county/FDEP criteria instead of the incorporated DRI retention standard needs an amendment.

AO11 · May 30, 2014 · PDF p. 2
2020 COUNTY INTERPRETATION

The 1984 NOPC changed the standard

County correspondence attributes a change to the 1984 action. Obtain adopted text and exhibits to reconcile it.

AO04 · February 5, 2020 · PDF p. 1

Meaning: differing historical interpretations warrant reconciliation. They do not establish which standard now governs Raven, absence of later amendments or misconduct.

Keep durations, rainfall and runoff separate

AO07 original PDF p. 3 refers to 0.75 inch, not OCR 0.78, and a 3-year/1-hour event of 2.66 inches. Reconcile that with the later 3-year/24-hour 6.7-inch rainfall reference; these are different events. AO15 PDF p. 3 calculates 6.7 inches rainfall × 0.37 ≈ 2.48 inches runoff equivalent under a proposed interpretation. Rainfall is not runoff. AO14 slide 5 is advocacy, not controlling law.

AO07 p. 3 · AO15 pp. 2–3 · AO14 slide 5

Your next useful step

Ask for a reconciled record and verified drainage analysis. Use the editable commissioner letter, share this page, or send dated local flooding evidence for review.

Personalize your letterShare with neighborsSend flooding evidence

October 21 recording: Motion to move Raven to Planning Commission without recommendation, with open questions/comments to be addressed first. Numerical vote and exact comment deadline remain unverified. County Planning reports the next hearing scheduled for November 12, with the project-specific notice still to verify. Recording and verification limits.

How the record developed

  1. February 11, 2026 · Meeting recorded
    The staff report lists a pre-application meeting; underlying notes and concept plans remain to be obtained. Source.
  2. March 20, 2026 · Applicant narrative
    Describes the phases, Parcel 209 transfer and 6.3-acre open-space reduction. Source.
  3. April 21, 2026 · Allocation letter
    Proposes different donor parcels and a maximum 9.52-acre open-space reduction. Source.
  4. October 7, 2026 · Published TRC packet
    Staff identifies unresolved review items and recommends conditional approval. This does not establish the meeting's outcome or a final approval. Source.
  5. October 21, 2026 · TRC recording
    Motion to move Raven to Planning Commission without recommendation, with open questions/comments addressed before that step; second and voice vote recorded. Certified tally, later hearing date and final approval remain unverified. Recording · 1:37:13 onward.

What is proposed

The March 20 narrative describes replacing the driving range and practice facilities with 22 detached homes and an interior road, with 24 villas contemplated later. The engineering master-plan table instead lists 22 future multifamily units. The final later-phase count and approval scope need clarification. This proposal does not establish permanent closure of the entire golf course.

Read the applicant narrative

What still needs an answer

  1. Which parcels supply the development rights, and does the final ledger reconcile?
  2. Which open-space reduction applies—6.3 or 9.52 acres—and what remains protected?
  3. Which land-use labels and standards control the review?
  4. What would be approved now, and what remains conceptual?
  5. Where does runoff discharge, and what do the models show for neighboring properties and receiving waters?

The county staff report identifies conflicting figures and unresolved review items. These warrant written answers; discrepancies alone do not prove wrongdoing.

Read the county staff report

Current performance needs its own evidence

Drainage: compare existing/proposed peak flow, runoff volume, water level and inundation duration using approved criteria, native models and accepted as-builts. Map shared assets and outfalls before transferring Driftwood conclusions to Raven; aerial proximity does not establish a hydraulic connection.

Utilities: distinguish permitted/design capacity, actual average/peak demand, committed future demand and local pipe/lift-station/distribution capacity. A plant annual average cannot clear local wet-weather or pressure constraints. Current permits, reservations, seasonal records and accepted asset drawings remain needed.

Reported leaks: a concern requiring verification, not an established condition or health-danger finding. Seek dated asset/location records, repairs, pressure logs, overflow reports, sampling, advisory issue/rescission and regulator closure. A leak report does not establish contamination.

Favorable evidence must remain visible

SWUCI’s 2025 report p. 3 reports a July TTHM sample of 170 ppb at SS #24, but explains the site annual average did not result in an MCL violation. Location relative to Raven and any relation to leaks are unverified. An annual report does not resolve every localized 2026 incident.

Harper, printed p. 31 / PDF p. 35, finds historical DRI deficiencies alongside favorable interior-system county-standard and shared-outfall conclusions. DEP correspondence AO01 p. 1 reports inspected pond compliance. Neither is blanket Raven clearance.

Find the promise before judging the loss

Private golf access, public recreation concurrency and DRI open space are distinct. Match the specific practice-facility conversion to adopted Map H/Exhibit E, acreage definitions, recorded rights/amendments and replacement conditions. The 6.3- versus 9.52-acre comparison is an accounting question, not proof of unlawful loss.

AO13 p. 2 concerns a historical Parcel 561 plat/master-plan issue, not current Raven obligations. AO09’s reversal/remand does not invalidate all approvals or establish public golf-access rights.

Follow the document trail

Start with the short explanation. Expand each item for the source, the comparison to make, and what remains unresolved.

TRC-2026-10-07-01 · DATED MEETING EXPLANATION

October 7 TRC: litigation question and response

A committee member asks whether the matter is still under litigation and how further development can proceed. The response describes no injunction at that point in the October 7 meeting, explains an appeal/remand notice issue and distinguishes the 2016 open-space amendment from litigation over a 2017 amendment.

Watch the exchange · 31:28–32:55 (YouTube)

Question, answer, source and verification limits

Recording: Technical Review Committee - Oct 07 2026, identified in the project source review as Walton County Government’s official recording. The official county agenda independently confirms the meeting date and Raven agenda item.

31:37–31:39: the supplied exported transcript reads, “is it under litigation still?” The member then asks about continued building and whether development is stopped. 32:03–32:52: the responding speaker, addressed as Brooke in the supplied transcript review, gives the dated explanation summarized above.

Attribution: we use “a committee member.” The chair’s address transcribed as Darren and the district’s identification of Darrin Dunwald as director are consistent, but do not independently confirm the voice. No definitive named-speaker attribution is made.

Separate statement: a public commenter at 19:04–19:21 asserted noncompliance. Do not conflate that allegation with the committee question, the response or an official finding.

Limits: summary and short quotation come from a supplied exported-transcript review with name errors, not an independent audio transcription. YouTube retrieval was throttled in this session; audio, speaker identity and exact channel attribution were not independently reverified here. The October 7 response does not establish today’s injunction status, an official DRI noncompliance finding, a blanket development prohibition or final Raven approval. Obtain later docket entries and operative orders for current legal effect.

Read the public-safe evidence index · TRC-2026-10-07-01 (JSON). This index is a derivative summary, not the full transcript or original recording. The county-hosted agenda and YouTube recording remain the underlying public sources.

Open the complete county packet · PDF, 84 pages, about 72 MB

Page references below use the complete packet's PDF page numbers. Page jumps depend on your PDF viewer. These are county-hosted source records; our summaries are preliminary analysis.
CONFIRMED DATE · UNDERLYING NOTES NOT YET LOCATED

February 11, 2026: pre-application meeting

The county staff report records a meeting with the applicant on this date. That is a precise starting point for tracing the original proposal.

See the source and the missing records

Complete packet, page 5 · Staff report, page 4.

Still needed: the meeting request, separate tracking number, initial concept plans, staff notes or written comments, and follow-up correspondence. These are not listed among the packet's attachments; the underlying pre-application file has not been recovered in this review.

Compare the initial unit count, phases, drainage footprint and requested studies against the current application. Search by Parcel 428, all four county parcel IDs, ECAE and the owners, as well as Raven.

DOCUMENT FOUND · ENTITLEMENT HISTORY NEEDS RECONCILIATION

Where the 22 development rights would come from

An April 21, 2026 ECAE letter proposes 16 units from Parcel 224A (Osprey Point) and 6 from Parcel 320.1 (Grand, Lasata, Bahia and Elation).

Read the allocation letter and follow its references

Density allocation and open-space letter, packet pages 77–78. Maps and entitlement excerpts follow in the packet.

The letter cites Exhibit E of the Sandestin 2024 Biennial Report as the approved pre-transfer allocation. The complete report, approval and subsequent allocation changes still need to be obtained and checked. Its stated post-transfer balances are 0 remaining units on 224A, 80 on 320.1 and 22 on 428.

The staff report flags a different donor, Parcel 209, in the March 20 narrative. Compare the signed letters, controlling Exhibit E, approvals and dated revisions to establish which allocation governs and whether the same units remain available.

Different kinds of credits: residential development rights are separate from wetland mitigation-bank credits. Each has its own ledger and approval trail.

SOURCE MATERIAL AVAILABLE · TECHNICAL REVIEW OUTSTANDING

What the plans and environmental assessment cover

The packet includes a boundary/topographic survey, engineering construction plans, environmental assessment, traffic drawdown statement and existing-conditions materials.

Open the evidence and see the questions to test

Packet attachment index, page 1 · Environmental assessment begins on packet page 53.

The staff report describes an assessment of approximately 12.5 acres with no jurisdictional wetlands identified. Match its surveyed boundary to the proposed construction, drainage works and future-phase footprint. A current no-wetlands finding does not establish whether older conservation restrictions or mitigation obligations apply.

For drainage, obtain the native model, calculations, design storm assumptions, groundwater and receiving-water levels, outfall details, and maintenance obligations. Compare approved existing conditions with proposed conditions and impacts on neighboring properties. The public packet is not a substitute for independent verification of the model.

Historical evidence: read both sides

These public-safe summaries cite preserved originals by AO identifier and original page number. They are analysis/transcription, not complete source files. Original-record availability: historical PDF/PPT originals are preserved privately. No reviewed redacted PDF/PPT copies are offered for public download in this update; only the summaries below are available here. Public copies require a separate redaction and metadata review. No private inbox links or source-email headers are included.

14 unique originals cover 15 attachment occurrences; AO10 duplicates AO03. The completed independent review covered 189 unique PDF pages and 6 slides. OCR is a search aid, not controlling text.

AO01 · DEP correspondence on inspected ponds

March 31, 2025 · PDF p. 1

DEP reports inspected pond compliance; the correspondent disputes which facilities are at issue. Clipped text is not reconstructed. No blanket Raven clearance.

AO02 · Dean Burgis deposition on stormwater criteria

July 22, 2026 · Printed p. 49 lines 6–17 / PDF p. 13; printed pp. 52–53 / PDF p. 14

Witness recollection does not establish that a proposed amendment was never submitted. Retain testimony about county-approved plans and his understanding of adopted criteria. Testimony is not an adopted amendment or judicial ruling.

AO03 · Public Works draft memorandum on Driftwood priorities

March 25, 2019 · PDF pp. 1–2, items 1–17

The original p. 1 bears a faint DRAFT watermark. Treat this as a historical draft staff summary, not adopted county policy. It reports both DRI deficiencies and favorable interior-system conclusions, and distinguishes conveyance improvements from treatment. AO10 is a byte-identical duplicate, not independent corroboration.

AO04 · County correspondence interpreting the 1984 NOPC

February 5, 2020 · PDF p. 1

Attributes a standards change to the 1984 action. Obtain adopted text, exhibits and later amendments before treating the interpretation as the governing legal standard.

AO05 · Correspondence summarizing Harper and county criteria

Historical correspondence · PDF p. 1 and email chain

Contains overlapping correspondence also appearing in AO04. Repetition is not independent corroboration; neither the summary nor the filename establishes misconduct.

AO06 · Historical Sandestin non-substantial-deviation order

Historical scan; full adoption chain unresolved · Original order and incorporated exhibits

This supplied order scan is part of the historical approval trail. Its full exhibits, subsequent amendments, current parcel applicability and any rescission/abandonment must be obtained.

AO07 · Sandestin stormwater review meeting notes

September 30, 2008 · PDF p. 3

Original text reads 0.75 inch, not OCR 0.78. Its 3-year/1-hour 2.66-inch reference must not be conflated with a 3-year/24-hour 6.7-inch rainfall event. Notes and unidentified handwritten annotations are not adopted standards.

AO08 · Request for clarification of DRI stormwater review

May 11, 2010 · PDF p. 1

Horner asks for clarification, including whether reviews should be held. This request itself is not a hold order or final agency answer.

AO09 · First DCA opinion: Osborne v. Walton County

February 12, 2025 · Majority ends / concurrence starts at PDF p. 18; disposition within majority

The majority reverses summary judgment and remands. Relevant counterevidence includes the absence of objection to the 2016 NOPC and rescission of the 2014 DONC in 2017. A concurrence is not the majority holding; the opinion does not invalidate all approvals. Later mandate and trial-court orders remain needed.

AO11 · DEO letter on Sandestin DRI compliance issues

May 30, 2014 · PDF pp. 2–3

The historical agency position calls for an amendment if relying on county/FDEP stormwater criteria. Page 3 distinguishes a developer-specific substantial-compliance determination; do not turn this into a universal prohibition on all Sandestin permits.

AO12 · Harper/ERD Driftwood stormwater evaluation

November 2018 · Printed p. 31 / PDF p. 35; criteria printed p. 16 / PDF p. 20

Finds historical DRI deficiencies while finding interior systems meet county water-quality/peak-rate criteria and no adverse shared-outfall effect from interior development. Major supporting appendices are absent. These historical conclusions do not establish current Raven performance.

AO13 · DCA inquiry on stormwater, access and evacuation

May 14, 2007 · PDF pp. 1–3; recreation/plat comparison p. 2

Requests county comment before considering enforcement. Reported concerns are not a final finding. Its historical Parcel 561 comparison does not decide Raven’s recreation obligations.

AO14 · Historical stormwater litigation presentation

Undated · 6 slides; rainfall/runoff discussion slide 5

An advocacy presentation, not controlling law. Slide 5 conflates rainfall/runoff; the review does not adopt that conflation. Rainfall is not runoff.

AO15 · Dantin/ECA proposed criteria and Sandestin modeling

Cover December 14, 2009; report November 29, 2009 · PDF pp. 1–4; p. 3 calculation; report Northside/storage and Weir 30 sections

Proposed interpretation: 6.7 inches rainfall × 0.37 ≈ 2.48 inches runoff equivalent. Favorable modeled Northside storage is 11.705 million cubic feet versus 11.215 million required under that interpretation. A Weir 30 rise of 0.53 foot versus 0.5 foot is addressed by a consultant exception; an adopted waiver is not established. Proposal/model results are not proof of adopted criteria or present Raven performance.

Trace the permits to the land

Coverage still to verify: no approved authorization boundary has been matched to this construction footprint in this review. An October 16 NWFWMD staff reply reports no permits found within the listed parcels and refers to the Sandestin DRI. This does not establish absence of authorization or an exemption, and a DRI reference alone does not identify environmental coverage. The targeted follow-up seeks its existing basis and agency routing.

Project identifiers for cross-searching

County project: MAJ26-000007 · Sandestin DRI Parcel 428 · ECA project 25-051 · Troon Drive, Miramar Beach. Owners named in the county record: Sandestin Investments LLC, Sandestin Holdings LLC and Sandestin Owners Association Inc. Applicant: Dean A. F. Burgis, ECAE LLC.

  • 26-2S-21-42000-001-0000
  • 26-2S-21-42000-001-0001
  • 26-2S-21-42000-001-00A0
  • 26-2S-21-42000-001-00B0

Section 26, Township 2 South, Range 21 West. DRI parcel numbers and county tax parcel IDs are different identifiers. A section-level match or matching owner alone does not demonstrate permit coverage.

State permits, older master permits and modifications

Check for an existing master authorization, modifications, pending applications, exemptions and any qualifying DEP self-certification. Match approved permit boundaries, drainage basins and outfalls to the surveyed construction footprint.

NWFWMD public permitting search · DEP public records search · DEP guide to finding ERP records.

Wetland mitigation-bank credit transactions

DEP's published ledgers are another route to an impact-permit number. Cross-search project and predecessor names, owners and permit numbers; then trace any debit to the impact permit and approved map. No transaction has been verified as covering Raven in this review.

DEP mitigation-bank ledgers · Army Corps RIBITS bank records.

Check the ledger date, bank service area, credit type, quantity, debit approval and any return or correction. DEP handles mitigation-bank permitting within NWFWMD boundaries. A bank credit addresses its specified mitigation obligation; flood protection and pollutant transport require separate evidence.

Conservation easements, plats and original development approvals

Trace the original Sandestin DRI development order and amendments, recorded conservation easements and plats, and any Army Corps permits identified by those records. Compare legal descriptions and approved maps with the Raven footprint; a Sandestin-wide name match is only a lead. No conservation restriction has yet been verified as covering this construction footprint.

Walton Clerk official records search · County meeting records and approvals.

Six targeted requests sent

October 16, 2026, approximately 12:20–12:23 p.m. CDT. The local executor verified sending in Sent. SENT does not mean delivered, acknowledged, answered or resolved. Delivery/acknowledgment/substantive responses to these six requests have not been verified for this update. No fees were authorized.

Earlier correspondence and missing records

The October 14 county and NWFWMD requests predate these supplements. An October 16 NWFWMD reply reports no permits found within the identified parcels and refers to the Sandestin DRI. That limited search does not establish absence of authorization, an exemption or complete DRI/environmental clearance. The new supplement seeks the existing basis and routing.

Controlling amendments, accepted as-builts, current commitments/reservations and peak-demand/incident records remain unresolved. The February 11 pre-application file and controlling 2024 Biennial Report Exhibit E remain sought. The October 21 consideration is confirmed above; County Planning reports November 12 for the next hearing, with its official project notice and exact comment cutoff still unverified.

Private sending addresses, individual correspondence and unredacted attachments are excluded from this public tracker. New records will be reviewed before public summaries change.

Protect the water that connects us

The Good Samaritan Institute’s SaveOurBay project describes one pooled sample of livers from 13 catfish collected at Ditch #10 in Santa Rosa Beach. The linked Pace report documents PFAS detections in the sample identified as catfish livers. This is an existing watershed concern—not a finding that Raven caused contamination. It does not measure edible fillets or establish a hydrologic connection to this project.

Our request: verify the drainage pathway, assess potential pollutant mobilization, and establish appropriate baseline testing before disturbance where supported by the evidence.

Sampling location and pooling details are attributed to the project’s account; they have not been independently reconstructed here. One pooled sample cannot establish how common contamination is across the bay or how much each fish contributed.

Read the full laboratory report · Read the sampling project’s account

What the community is asking for

Recorded action / approval status: The October 21 official recording contains a motion to move Raven to the Planning Commission without recommendation, requiring open questions and comments to be addressed before that step (1:37:13–1:38:55). It was seconded and put to a voice vote (1:39:04–1:39:35), after which the meeting moved to the next item. A certified numerical tally and voter identities have not been located. This is not final development approval.

Check official county meetings and records

Help your neighbors understand Raven

Share the proposal, the unanswered questions and the call for independent flood and water-quality review.

Instagram and TikTok: Copy the caption below for your post, Story or video. Add the published page link wherever your account supports links. Direct posting is not provided by this page.

Download social graphic Download Story / TikTok graphic

Share this evidence review with your neighbors. Posting availability varies by device and app.

Write your commissioners

Personalize the letter, choose a recipient and review the draft in your email app before sending. Contacting commissioners does not automatically place comments into the project record or preserve any review rights. Ask county planning for the proper submission channel.

Open draft to all five commissioners

Addresses checked against the official county directory October 14, 2026. Messages to public officials may become public records; omit sensitive personal information.Official commissioner directory

Share evidence and local experience

Document flooding with dates, locations, rainfall context and photographs when available. Send source documents or corrections to Protect30A for review. Submissions are not automatically published or submitted to the county.

Share evidence with Protect30A

Neighborhood cleanup planning

Separately, Protect30A is gathering neighborhood needs for a storm debris and fallen-limb cleanup pilot. Cleanup bookings, online photo reporting, and pickup tracking are not yet available.

Share cleanup needs with a general location and brief description. This is a planning inquiry, not a service booking or an official county submission.

Accuracy, competing evidence and limits

Review update · October 16, 2026: this is a public advocacy summary of a preliminary documentary review. It is not a peer-reviewed study, independent engineering certification or finding that the project causes flooding or pollution. “Protect the Bay. Prevent More Flooding.” states the campaign’s goal, not an established project impact.

What did the October 7 litigation exchange establish?

The meeting includes a litigation question and a response describing no injunction at that point, with an explanation of notice/remand and different amendment proceedings. This is dated meeting testimony/explanation, not an independent current legal conclusion. The separate commenter’s noncompliance assertion is an allegation, not an official determination. Speaker identities and the transcript’s names remain qualified.

Read the source card, timestamps and limitations · Watch from 31:28 (YouTube). Later court orders and controlling amendments remain needed.

What the record also says in the project’s favor

The staff report recommends approval with conditions. Its floodplain reviewer reports no outstanding floodplain issues and describes approximately 6,194 cubic feet of fill with 138,724 cubic feet of additional storage. The environmental summary reports no jurisdictional wetlands and no observed evidence of hazardous materials or contamination. These findings belong in a balanced account.

Other engineering and planning items remain unresolved in that same report. A visual observation of no contamination is not chemical testing; a floodplain review is not independent verification of all drainage impacts. Floodplain comments · packet pages 6–7 · Environmental comments · page 8 · Recommendation · page 10.

Additional differences found during this source audit
  • Later-phase unit count: the narrative describes 24 villas; the engineering master-plan table lists 22 multifamily units and 44 units overall (22 + 22). Identify the controlling revision and approval scope. Narrative · page 15 / Master-plan table · page 26.
  • Assessment chronology: the environmental assessment states a field survey on December 15, 2026, later than the October 7 packet. Staff instead references an assessment dated January 19, 2026. Obtain the corrected date, original report and field records; a date error does not establish that the survey never occurred. Assessment · page 53 / Staff reference · page 6.
  • Legal-location label: the engineering cover says Section 23, while the narrative and internal plan sheet identify Section 26, Township 2 South, Range 21 West. Confirm the correct legal description and whether the cover requires correction. Cover · page 24 / Narrative · page 15 / Plan · page 26.
  • Permit-route eligibility: staff mentions an ERP or qualifying “10-2” self-certification, but the engineering table lists an 11.09-acre master-plan site and 6.11 acres of Phase I impervious surface. Those figures need agency reconciliation with the stated less-than-10-acre and less-than-2-acre thresholds. No eligibility, exemption or violation is established here. Staff condition · page 4 / Plan table · page 26.

These observations were checked visually on the source pages. Different dates, scopes or plan revisions may explain some differences; an agency or applicant response has not been verified in this review.

How this review was conducted—and how to reproduce it

We compared the narrative, staff report, allocation letter and selected engineering and environmental pages within the county-published 84-page packet. Text extraction was checked against rendered pages for the newly reported date, location and plan-table differences. Links identify complete-packet PDF pages. The source remains authoritative; the summaries and suggested actions are AI-assisted interpretation.

The independent historical-document review covered all 14 unique originals, including the six-slide presentation. Exact adopted standards, later amendments and current parcel applicability still require the controlling record. The AO03 DRAFT watermark, storm-duration/rainfall/runoff distinctions, AO09 majority/concurrence boundary and counterevidence are retained above.

Permit searches were exploratory, not an exhaustive historical title or permit search. No native drainage model was rerun, no field survey or sampling was performed for this review, and responses to the six new targeted requests have not yet been verified. The limited October 16 NWFWMD reply to the earlier inquiry is described above. Our absence of a record is not proof the record does not exist. Favorable findings and unresolved questions are reported together.

Download archived October 14 packet source register and SHA-256 fingerprint. This archived register documents the October 14 packet review; it does not inventory the new historical summaries or six sent requests. The fingerprint identifies the retrieved packet version; it does not authenticate the accuracy of its contents. A later corrected packet may have a different fingerprint.

Corrections and source-backed responses are welcome at digitalcommons@icloud.com.

Sources and update log

October 23, 2026 · 8:22 a.m. CDT: Reviewed the assigned planner’s 7:48 a.m. forwarding acknowledgment. Added confirmed routing of the drainage-report and revised-civil-plans request to county engineering, separately from document delivery and issue acceptance. Official public project-status portal. No engineering issue, hearing procedure or written TRC condition is marked resolved; no new request was sent. Prepared by ChatGPT for Doug Liles from current official correspondence reviewed privately.

October 22, 2026 · 2:01 p.m. CDT: Reviewed the assigned planner’s 11:55 a.m. reply. Added the attributed November 12 hearing schedule and provisional no-consensus characterization. Formal written disposition, hearing notice, time/location, exact comment cutoff, carry-forward rule and engineering acceptance remain unverified. Prepared by ChatGPT for Doug Liles from current official staff correspondence reviewed privately; no private email text or mailbox links published. Six earlier RAV requests and all unresolved engineering issues remain separately dated and open.

October 22, 2026 · 11:49 a.m. CDT: Added the verified 11:44 a.m. consolidated follow-up as sent/pending, with separate disposition, hearing/participation and engineering-closure tracks. Added a concise hearing-preparation checklist. Source: privately reviewed current Sent correspondence; no private email text, headers or mailbox links published. County receipt, project-record inclusion and responses are not inferred. The 10:11 recording update, personal-capacity disclaimer and all six separately dated records-request tracks are preserved.

October 22, 2026 · 10:11 a.m. CDT: Reviewed the official October 21 recording and auto-generated English captions: Raven starts 1:01:18; engineering review status 1:33:39; motion 1:37:13; clarification 1:37:59; voice vote 1:39:13. Added the recorded forwarding motion without recommendation and its prerequisites. No final approval, certified tally or drainage closure is asserted. Official Walton County recording. Earlier filing history, historical evidence cautions, personal-capacity disclaimer and six-request statuses are preserved with their original dates.

October 21, 2026 · 8:56 a.m. CDT: Updated the meeting status, October 18–21 filing timeline and request for documented drainage-review closure. Prepared by ChatGPT for Doug Liles from the official October 21 agenda, county planner’s October 19 upload confirmation and verified October 21 sent follow-up. No committee outcome or substantive engineering closure is established. October 7 packet comparisons remain historical; they have not been relabeled as findings from the October 21 packet.

October 16, 2026 · TRC evidence addition: added TRC-2026-10-07-01, the October 7 litigation exchange at 31:28–32:55, with both question and response, separate-commenter distinction and explicit transcript/audio/attribution limits. Public-safe index added; no unredacted transcript or private correspondence published.

October 16 evidence update: four priority questions; provider/criteria comparisons; present-performance/recreation paths; explicit favorable evidence; 14 sanitized historical summaries; six-request SENT tracker. Full original public copies await redaction review. Private source inventory is maintained separately from this public summary. No current contamination, dangerous leaks, capacity violation or unlawful recreation loss is established. Published following owner approval; unresolved source limitations remain stated.

Archived October 14 preliminary review · October 16 historical summaries. The archived review may contain superseded correspondence status; use the dated tracker above. Full engineering-model verification remains outstanding.

Applicant narrative, March 20; county staff report and TRC agenda, October 7; Pace laboratory report, May 21, 2024; official commissioner directory, checked October 14, 2026.

October 7 agenda

October 14, 2026, 8:08 p.m. CDT: Audited source pages and corrected stale statements in the detailed review. Added favorable findings, later-phase count and chronology differences, legal-location and permit-route questions, sampling-provenance limits and a reproducible source register. The map, comparisons, timeline and source layers remain available. Records correspondence now uses digitalcommons@icloud.com. Engineering-model verification, permit-boundary matching and the next project hearing remain unresolved. Updated manually.
